āļ”āļĢāļ­āļ›āļŠāļīāļ›āđ„āļ›āļĒāļąāļ‡āļœāļđāđ‰āļĢāļąāļšāđ€āļŦāļĄāļēāļŠāđˆāļ§āļ‡Âķ

In the Dropship to Subcontractor workflow, a company purchases the components of a product from a vendor, who delivers them directly to the subcontractor for manufacturing. The subcontractor then ships the finished product back to the company.

The following documentation covers how to configure a subcontracted product and walk through the Dropship to Subcontractor workflow.

Note

This document uses the term company to refer to the internal company requiring subcontracted goods, and the term subcontractor to refer to the external vendor handling the outsourced production of the subcontracted goods.

āļāļēāļĢāļāļģāļŦāļ™āļ”āļ„āđˆāļēÂķ

To use the Dropship to Subcontractor workflow, companies must first configure subcontracted products with a vendor pricelist and a subcontracting-type BoM specifying the product's components. Companies must then configure each component by specifying a dropship vendor and an appropriate route.

The pricelist allows the company to purchase the product from the vendor (subcontractor) through a PO. The BoM allows the product to be manufactured externally by the subcontractor. Routes are applied to each component in order to be properly sent from the dropshipping vendor to the subcontractor.

Important

In order to configure product components for dropshipping, make sure that the Dropshipping feature is enabled in the NightPOS settings.

To do so, navigate to either the Inventory or Purchase app, then click Configuration â€Ģ Settings. Finally, in the Logistics section, enable the Dropshipping setting.

āļ•āļąāđ‰āļ‡āļ„āđˆāļēāļœāļđāđ‰āļˆāļģāļŦāļ™āđˆāļēāļĒāļŠāļīāļ™āļ„āđ‰āļēÂķ

To configure a product's vendor for dropship subcontracting, navigate to Inventory app â€Ģ Products â€Ģ Products, and select a product, or create a new one.

āđƒāļ™āđāļšāļšāļŸāļ­āļĢāđŒāļĄāļŠāļīāļ™āļ„āđ‰āļē āļ„āļĨāļīāļāđāļ—āđ‡āļš āļāļēāļĢāļˆāļąāļ”āļ‹āļ·āđ‰āļ­ āđāļĨāļ°āđ€āļžāļīāđˆāļĄāļœāļđāđ‰āļĢāļąāļšāļˆāđ‰āļēāļ‡āļŠāđˆāļ§āļ‡āđ€āļ›āđ‡āļ™āļœāļđāđ‰āļ‚āļēāļĒāļ‚āļ­āļ‡āļŠāļīāļ™āļ„āđ‰āļēāđ‚āļ”āļĒāļ„āļĨāļīāļ āđ€āļžāļīāđˆāļĄāļšāļĢāļĢāļ—āļąāļ” āđ€āļĨāļ·āļ­āļāļœāļđāđ‰āļĢāļąāļšāļˆāđ‰āļēāļ‡āļŠāđˆāļ§āļ‡āđƒāļ™āđ€āļĄāļ™āļđāđāļšāļšāđ€āļĨāļ·āđˆāļ­āļ™āļĨāļ‡ āļœāļđāđ‰āļ‚āļēāļĒ

Then, enter the price of the product in the Unit Price field.

Finally, set a Lead Time for the product in the corresponding field to specify the number of days for the subcontractor to receive components, produce the product, and deliver the finished good.

Note

Companies do not need to configure manufacturing lead times on a BoM. Instead, provide only a single Lead Time on the vendor pricelist, factoring in the duration for the subcontractor to receive the components from the dropship vendor, manufacture the product, and deliver the finished good back to the company.

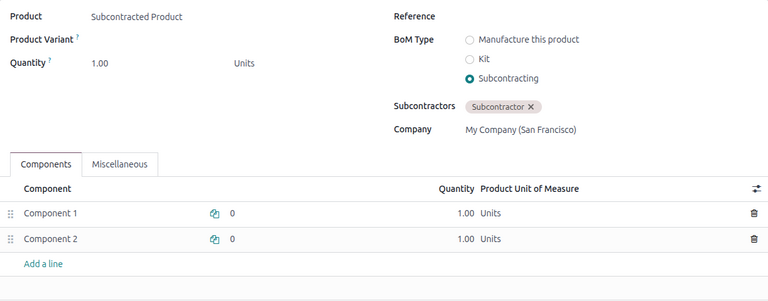

āļāļģāļŦāļ™āļ”āļ„āđˆāļē BoMÂķ

āļŦāļĨāļąāļ‡āļˆāļēāļāļĢāļ°āļšāļļāļœāļđāđ‰āļ‚āļēāļĒāđāļĨāđ‰āļ§ āđƒāļŦāđ‰āļāļģāļŦāļ™āļ”āļ„āđˆāļē BoM āļ›āļĢāļ°āđ€āļ āļ—āļĢāļąāļšāļˆāđ‰āļēāļ‡āļŠāđˆāļ§āļ‡āļŠāļģāļŦāļĢāļąāļšāļŠāļīāļ™āļ„āđ‰āļē āđƒāļ™āļāļēāļĢāđ€āļĢāļīāđˆāļĄāļ•āđ‰āļ™ āđƒāļŦāđ‰āļ„āļĨāļīāļāļ›āļļāđˆāļĄāļ­āļąāļˆāļ‰āļĢāļīāļĒāļ° Bill of Materials āļšāļ™āļŦāļ™āđ‰āļēāļŠāļīāļ™āļ„āđ‰āļē āļˆāļēāļāļ™āļąāđ‰āļ™āđ€āļĨāļ·āļ­āļ BoM āļ—āļĩāđˆāļ•āđ‰āļ­āļ‡āļāļēāļĢāļŦāļĢāļ·āļ­āļŠāļĢāđ‰āļēāļ‡āđƒāļŦāļĄāđˆ

Tip

āļŦāļĢāļ·āļ­āđ„āļ›āļ—āļĩāđˆ āđāļ­āļ›āļāļēāļĢāļœāļĨāļīāļ• â€Ģ āļŠāļīāļ™āļ„āđ‰āļē â€Ģ āļĢāļēāļĒāļāļēāļĢāļ§āļąāļŠāļ”āļļ āđāļĨāļ°āđ€āļĨāļ·āļ­āļ BoM āļŠāļģāļŦāļĢāļąāļšāļŠāļīāļ™āļ„āđ‰āļēāļ—āļĩāđˆāļˆāđ‰āļēāļ‡āđ€āļŦāļĄāļēāļŠāđˆāļ§āļ‡

āđƒāļ™āļŸāļīāļĨāļ”āđŒ āļ›āļĢāļ°āđ€āļ āļ— BoM āđ€āļĨāļ·āļ­āļāļ•āļąāļ§āđ€āļĨāļ·āļ­āļ āļĢāļąāļšāļˆāđ‰āļēāļ‡āļŠāđˆāļ§āļ‡ āļˆāļēāļāļ™āļąāđ‰āļ™āđ€āļžāļīāđˆāļĄāļœāļđāđ‰āļĢāļąāļšāļˆāđ‰āļēāļ‡āļŠāđˆāļ§āļ‡āļŦāļ™āļķāđˆāļ‡āļĢāļēāļĒāļ‚āļķāđ‰āļ™āđ„āļ›āđƒāļ™āļŸāļīāļĨāļ”āđŒ āļœāļđāđ‰āļĢāļąāļšāļˆāđ‰āļēāļ‡āļŠāđˆāļ§āļ‡

āļŠāļļāļ”āļ—āđ‰āļēāļĒ āļ•āļĢāļ§āļˆāļŠāļ­āļšāđƒāļŦāđ‰āđāļ™āđˆāđƒāļˆāļ§āđˆāļēāļĢāļ°āļšāļļāļŠāđˆāļ§āļ™āļ›āļĢāļ°āļāļ­āļšāļ—āļĩāđˆāļˆāļģāđ€āļ›āđ‡āļ™āļ—āļąāđ‰āļ‡āļŦāļĄāļ”āđƒāļ™āđāļ—āđ‡āļš āļŠāđˆāļ§āļ™āļ›āļĢāļ°āļāļ­āļš āđāļĨāđ‰āļ§ āđ€āļĄāļ·āđˆāļ­āļ•āđ‰āļ­āļ‡āļāļēāļĢāđ€āļžāļīāđˆāļĄāļŠāđˆāļ§āļ™āļ›āļĢāļ°āļāļ­āļšāđƒāļŦāļĄāđˆ āđƒāļŦāđ‰āļ„āļĨāļīāļ āđ€āļžāļīāđˆāļĄāļĢāļēāļĒāļāļēāļĢ āđ€āļĨāļ·āļ­āļāļŠāđˆāļ§āļ™āļ›āļĢāļ°āļāļ­āļšāđƒāļ™āđ€āļĄāļ™āļđāđāļšāļšāđ€āļĨāļ·āđˆāļ­āļ™āļĨāļ‡ āļŠāđˆāļ§āļ™āļ›āļĢāļ°āļāļ­āļš āđāļĨāļ°āļĢāļ°āļšāļļāļ›āļĢāļīāļĄāļēāļ“āļ—āļĩāđˆāļ•āđ‰āļ­āļ‡āļāļēāļĢāđƒāļ™āļŸāļīāļĨāļ”āđŒ āļ›āļĢāļīāļĄāļēāļ“

BoM āļ‚āļ­āļ‡āļŠāļīāļ™āļ„āđ‰āļēāļ—āļĩāđˆāļĄāļĩāļŠāļīāđ‰āļ™āļŠāđˆāļ§āļ™āļ”āļĢāļ­āļ›āļŠāļīāļ›āđ„āļ›āļĒāļąāļ‡āļœāļđāđ‰āļĢāļąāļšāļˆāđ‰āļēāļ‡āļŠāđˆāļ§āļ‡

āļāļģāļŦāļ™āļ”āļ„āđˆāļēāļŠāđˆāļ§āļ™āļ›āļĢāļ°āļāļ­āļšÂķ

When dropshipping to subcontractors, each component of a product must have a specified vendor and have the Dropship route enabled. This allows the components to be properly dropshipped from the vendor to the subcontractor.

āļŦāļēāļāļ•āđ‰āļ­āļ‡āļāļēāļĢāļĢāļ°āļšāļļāļœāļđāđ‰āļˆāļąāļ”āļˆāļģāļŦāļ™āđˆāļēāļĒāļ‚āļ­āļ‡āļŠāđˆāļ§āļ™āļ›āļĢāļ°āļāļ­āļš āđƒāļŦāđ‰āđ€āļĨāļ·āļ­āļāļŠāļ·āđˆāļ­āļŠāđˆāļ§āļ™āļ›āļĢāļ°āļāļ­āļšāđƒāļ™āđāļ—āđ‡āļš Components āđāļĨāđ‰āļ§āļ„āļĨāļīāļāļĨāļđāļāļĻāļĢ (Internal link)

Tip

āļ­āļĩāļāļ—āļēāļ‡āļŦāļ™āļķāđˆāļ‡ āđ„āļ›āļ—āļĩāđˆ Inventory app â€Ģ Products â€Ģ Products āđāļĨāļ°āđ€āļĨāļ·āļ­āļāļŠāđˆāļ§āļ™āļ›āļĢāļ°āļāļ­āļš

āđƒāļ™āļŸāļ­āļĢāđŒāļĄāļŠāļīāļ™āļ„āđ‰āļēāļŠāđˆāļ§āļ™āļ›āļĢāļ°āļāļ­āļš āļ„āļĨāļīāļāđāļ—āđ‡āļš Purchase āđ€āļžāļīāđˆāļĄāļœāļđāđ‰āļˆāļąāļ”āļˆāļģāļŦāļ™āđˆāļēāļĒāđ‚āļ”āļĒāļ„āļĨāļīāļ Add a line āļˆāļēāļāļ™āļąāđ‰āļ™āđ€āļĨāļ·āļ­āļāļœāļđāđ‰āļˆāļąāļ”āļˆāļģāļŦāļ™āđˆāļēāļĒāđƒāļ™āļŸāļīāļĨāļ”āđŒ Vendor

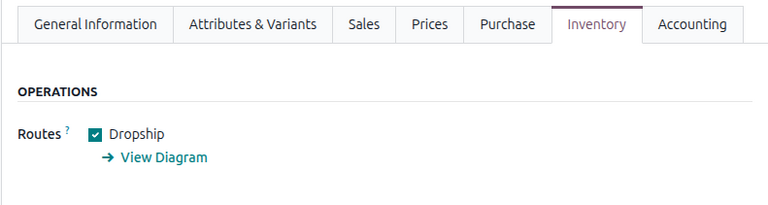

Next, to configure the route, click on the Inventory tab and select the Dropship route in the Routes section.

āļ—āļģāļ‹āđ‰āļģāļ‚āļąāđ‰āļ™āļ•āļ­āļ™āļ™āļĩāđ‰āļŠāļģāļŦāļĢāļąāļšāļ—āļļāļāļŠāđˆāļ§āļ™āļ›āļĢāļ°āļāļ­āļšāļ—āļĩāđˆāļˆāļ°āļ”āļĢāļ­āļ›āļŠāļīāļ›āđ„āļ›āļĒāļąāļ‡āļœāļđāđ‰āļĢāļąāļšāđ€āļŦāļĄāļēāļŠāđˆāļ§āļ‡

āđ€āļŠāđ‰āļ™āļ—āļēāļ‡āļŠāļģāļŦāļĢāļąāļšāļŠāđˆāļ§āļ™āļ›āļĢāļ°āļāļ­āļšāļ—āļĩāđˆāļˆāļ°āļ”āļĢāļ­āļ›āļŠāļīāļ›āđ„āļ›āļĒāļąāļ‡āļœāļđāđ‰āļĢāļąāļšāđ€āļŦāļĄāļēāļŠāđˆāļ§āļ‡

āđ€āļ§āļīāļĢāđŒāļ„āđ‚āļŸāļĨāļ§āđŒÂķ

āđ€āļ§āļīāļĢāđŒāļāđ‚āļŸāļĨāļ§āđŒ Dropship to Subcontractor āđ€āļĢāļīāđˆāļĄāļ•āđ‰āļ™āđ‚āļ”āļĒ āļāļēāļĢāļŠāļĢāđ‰āļēāļ‡ PO āđ€āļžāļ·āđˆāļ­āļ‹āļ·āđ‰āļ­āļŠāļīāļ™āļ„āđ‰āļēāļˆāļēāļāļœāļđāđ‰āļĢāļąāļšāđ€āļŦāļĄāļēāļŠāđˆāļ§āļ‡ (1)

The company then confirms the subcontractor PO (2). This creates an RfQ to purchase the components from the vendor, as well as a receipt to transfer the final product.

Next, the company confirms the RfQ, turning it into a vendor PO and creating a dropship order to send the components from the vendor to the subcontractor (3). Once the company validates the dropship order, the subcontractor begins to manufacture the final product with the components and ships it to the company when done.

Once the product has been produced and received, the company validates the receipt (6) to trigger inventory moves from the subcontractor to the company's stock (4, 5).

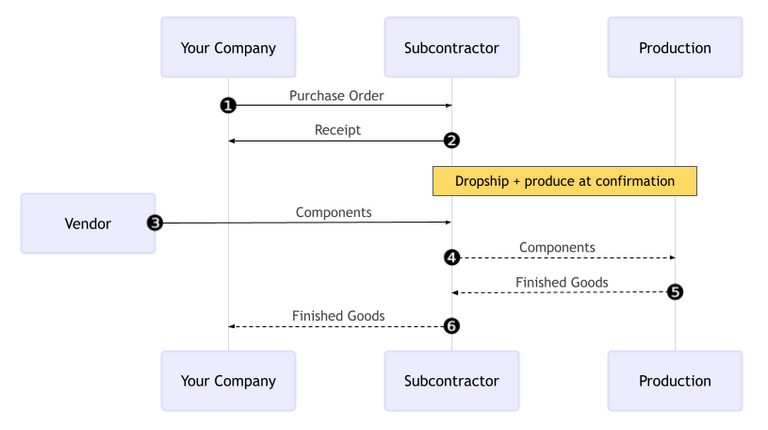

āđāļœāļ™āļ āļēāļžāļ‚āļ­āļ‡āđ€āļ§āļīāļĢāđŒāļāđ‚āļŸāļĨāļ§āđŒāļ”āļĢāļ­āļ›āļŠāļīāļ›āđ„āļ›āļĒāļąāļ‡āļœāļđāđ‰āļĢāļąāļšāđ€āļŦāļĄāļēāļŠāđˆāļ§āļ‡

āļŠāļĢāđ‰āļēāļ‡āđāļĨāļ°āļĒāļ·āļ™āļĒāļąāļ™ PO āļœāļđāđ‰āļĢāļąāļšāđ€āļŦāļĄāļēāļŠāđˆāļ§āļ‡Âķ

āđƒāļ™āļāļēāļĢāļŠāļĢāđ‰āļēāļ‡|PO|āļŠāļģāļŦāļĢāļąāļšāļŠāļīāļ™āļ„āđ‰āļēāļ—āļĩāđˆāļĢāļąāļšāļŠāđˆāļ§āļ‡āļāļēāļĢāļœāļĨāļīāļ• āđƒāļŦāđ‰āđ„āļ›āļ—āļĩāđˆ:menuselection:āđāļ­āļ›āļāļēāļĢāļˆāļąāļ”āļ‹āļ·āđ‰āļ­ --> āļ„āļģāļŠāļąāđˆāļ‡āļ‹āļ·āđ‰āļ­ --> āđƒāļšāļŠāļąāđˆāļ‡āļ‹āļ·āđ‰āļ­ āđāļĨāļ°āļ„āļĨāļīāļ:guilabel:āļŠāļĢāđ‰āļēāļ‡

āđ€āļĢāļīāđˆāļĄāļāļĢāļ­āļ|PO|āđ‚āļ”āļĒāđ€āļĨāļ·āļ­āļāļœāļđāđ‰āļĢāļąāļšāđ€āļŦāļĄāļēāļŠāđˆāļ§āļ‡āļˆāļēāļāđ€āļĄāļ™āļđāđāļšāļšāđ€āļĨāļ·āđˆāļ­āļ™āļĨāļ‡:guilabel:āļœāļđāđ‰āļˆāļģāļŦāļ™āđˆāļēāļĒ āđƒāļ™āđāļ—āđ‡āļš:guilabel:āļŠāļīāļ™āļ„āđ‰āļē āđƒāļŦāđ‰āļ„āļĨāļīāļ:guilabel:āđ€āļžāļīāđˆāļĄāļŠāļīāļ™āļ„āđ‰āļē`āđ€āļžāļ·āđˆāļ­āļŠāļĢāđ‰āļēāļ‡āļĢāļēāļĒāļāļēāļĢāļŠāļīāļ™āļ„āđ‰āļēāđƒāļŦāļĄāđˆ āđ€āļĨāļ·āļ­āļāļŠāļīāļ™āļ„āđ‰āļēāļ—āļĩāđˆāļĢāļąāļšāļŠāđˆāļ§āļ‡āļāļēāļĢāļœāļĨāļīāļ•āđƒāļ™āļŸāļīāļĨāļ”āđŒ:guilabel:`āļŠāļīāļ™āļ„āđ‰āļē āđāļĨāļ°āļ›āđ‰āļ­āļ™āļˆāļģāļ™āļ§āļ™āđƒāļ™āļŸāļīāļĨāļ”āđŒ:guilabel:āļˆāļģāļ™āļ§āļ™

After adding the product, the Expected Arrival field is updated with the finished product's expected delivery date, as configured earlier with the vendor's Lead Time.

āļŠāļļāļ”āļ—āđ‰āļēāļĒ āļ„āļĨāļīāļ Confirm Order āđ€āļžāļ·āđˆāļ­āļĒāļ·āļ™āļĒāļąāļ™ PO āđƒāļšāļĢāļąāļšāļˆāļ°āļ–āļđāļāļŠāļĢāđ‰āļēāļ‡āđ‚āļ”āļĒāļ­āļąāļ•āđ‚āļ™āļĄāļąāļ•āļī āđāļĨāļ°āļ›āļļāđˆāļĄāļ­āļąāļˆāļ‰āļĢāļīāļĒāļ° Receipt āļˆāļ°āļ›āļĢāļēāļāļāļ—āļĩāđˆāļ”āđ‰āļēāļ™āļšāļ™āļ‚āļ­āļ‡āļŸāļ­āļĢāđŒāļĄ āļ™āļ­āļāļˆāļēāļāļ™āļĩāđ‰ RfQ āđāļĒāļāļ•āđˆāļēāļ‡āļŦāļēāļāļˆāļ°āļ–āļđāļāļŠāļĢāđ‰āļēāļ‡āđ‚āļ”āļĒāļ­āļąāļ•āđ‚āļ™āļĄāļąāļ•āļīāđ€āļžāļ·āđˆāļ­āļ‹āļ·āđ‰āļ­āļŠāđˆāļ§āļ™āļ›āļĢāļ°āļāļ­āļšāļˆāļēāļāļœāļđāđ‰āļˆāļąāļ”āļˆāļģāļŦāļ™āđˆāļēāļĒāļ”āļĢāļ­āļ›āļŠāļīāļ›

Note

This RfQ is not automatically linked to the PO. It must be accessed separately on the Requests for Quotation page.

āļĒāļ·āļ™āļĒāļąāļ™ RfQ āļ‚āļ­āļ‡āļœāļđāđ‰āļ‚āļēāļĒÂķ

āļŦāļēāļāļ•āđ‰āļ­āļ‡āļāļēāļĢāļĒāļ·āļ™āļĒāļąāļ™ RfQ āļœāļđāđ‰āļˆāļąāļ”āļˆāļģāļŦāļ™āđˆāļēāļĒ āđƒāļŦāđ‰āđ„āļ›āļ—āļĩāđˆ Purchase app â€Ģ Orders â€Ģ Requests for Quotation āđ€āļĨāļ·āļ­āļ RfQ āļ—āļĩāđˆāļŠāļĢāđ‰āļēāļ‡āļ‚āļķāđ‰āļ™āđƒāļŦāļĄāđˆāļŠāļģāļŦāļĢāļąāļšāļœāļđāđ‰āļˆāļąāļ”āļˆāļģāļŦāļ™āđˆāļēāļĒāļ—āļĩāđˆāđ€āļŦāļĄāļēāļ°āļŠāļĄ

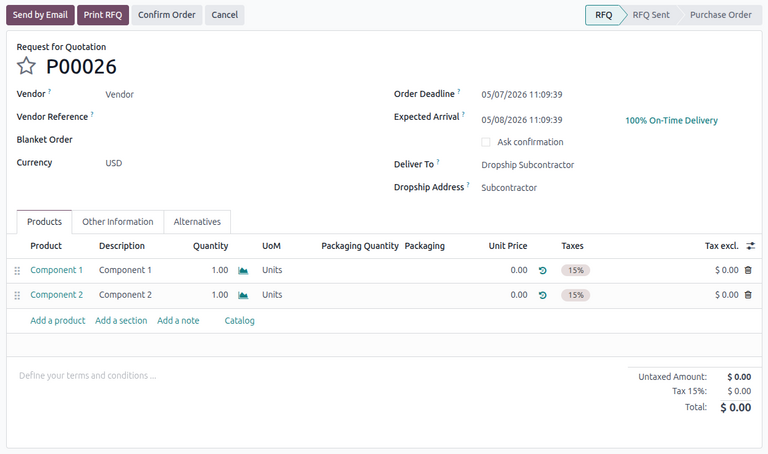

āđƒāļ™ RfQ āļŸāļīāļĨāļ”āđŒ āļŠāđˆāļ‡āđ„āļ›āļ—āļĩāđˆ āļˆāļ°āđāļŠāļ”āļ‡ āļ”āļĢāļ­āļ›āļŠāļīāļ›āļœāļđāđ‰āļĢāļąāļšāđ€āļŦāļĄāļēāļŠāđˆāļ§āļ‡ āđāļĨāļ°āļŸāļīāļĨāļ”āđŒ āļ—āļĩāđˆāļ­āļĒāļđāđˆāļŠāļģāļŦāļĢāļąāļšāļ”āļĢāļ­āļ›āļŠāļīāļ› āļˆāļ°āđāļŠāļ”āļ‡āļŠāļ·āđˆāļ­āļ‚āļ­āļ‡āļœāļđāđ‰āļĢāļąāļšāđ€āļŦāļĄāļēāļŠāđˆāļ§āļ‡āļ—āļĩāđˆāļŠāđˆāļ‡āļŠāđˆāļ§āļ™āļ›āļĢāļ°āļāļ­āļšāđāļšāļšāļ”āļĢāļ­āļ›āļŠāļīāļ›āđ„āļ›āđƒāļŦāđ‰

āļ„āļĨāļīāļ Confirm Order āđ€āļžāļ·āđˆāļ­āļĒāļ·āļ™āļĒāļąāļ™āļāļēāļĢāļ‹āļ·āđ‰āļ­āļŠāđˆāļ§āļ™āļ›āļĢāļ°āļāļ­āļšāļˆāļēāļāļœāļđāđ‰āļˆāļąāļ”āļˆāļģāļŦāļ™āđˆāļēāļĒ āļāļēāļĢāļ”āļģāđ€āļ™āļīāļ™āļāļēāļĢāļ™āļĩāđ‰āļˆāļ°āđ€āļ›āļĨāļĩāđˆāļĒāļ™ RfQ āđ€āļ›āđ‡āļ™ PO āļœāļđāđ‰āļˆāļąāļ”āļˆāļģāļŦāļ™āđˆāļēāļĒ āļ›āļļāđˆāļĄāļ­āļąāļˆāļ‰āļĢāļīāļĒāļ° Dropship āļˆāļ°āļ›āļĢāļēāļāļāļ—āļĩāđˆāļ”āđ‰āļēāļ™āļšāļ™āļ‚āļ­āļ‡ PO āļœāļđāđ‰āļˆāļąāļ”āļˆāļģāļŦāļ™āđˆāļēāļĒ

Note

āđƒāļ™āđ€āļ§āļĨāļēāđ€āļ”āļĩāļĒāļ§āļāļąāļ™ āļ›āļļāđˆāļĄāļ­āļąāļˆāļ‰āļĢāļīāļĒāļ° Resupply āļˆāļ°āļ›āļĢāļēāļāļāļ—āļĩāđˆāļ”āđ‰āļēāļ™āļšāļ™āļ‚āļ­āļ‡ PO āļœāļđāđ‰āļĢāļąāļšāđ€āļŦāļĄāļēāļŠāđˆāļ§āļ‡ āļ—āļĩāđˆāļŠāļĢāđ‰āļēāļ‡āđ„āļ§āđ‰āļāđˆāļ­āļ™āļŦāļ™āđ‰āļēāļ™āļĩāđ‰ āđƒāļ™āļāļēāļĢāļĢāļąāļšāđ€āļŦāļĄāļēāļŠāđˆāļ§āļ‡āđāļšāļšāļ”āļĢāļ­āļ›āļŠāļīāļ› āļ›āļļāđˆāļĄāļ­āļąāļˆāļ‰āļĢāļīāļĒāļ°āļ™āļĩāđ‰āļˆāļ°āđ€āļŠāļ·āđˆāļ­āļĄāđ‚āļĒāļ‡āđ„āļ›āļĒāļąāļ‡āļ„āļģāļŠāļąāđˆāļ‡āļ”āļĢāļ­āļ›āļŠāļīāļ›

āđƒāļšāđ€āļŠāļ™āļ­āļĢāļēāļ„āļēāļœāļđāđ‰āļ‚āļēāļĒāļŠāļģāļŦāļĢāļąāļšāļŠāđˆāļ§āļ™āļ›āļĢāļ°āļāļ­āļšāļ—āļĩāđˆāļˆāļąāļ”āļŠāđˆāļ‡āđāļšāļš dropship āļ‚āļ­āļ‡āļŠāļīāļ™āļ„āđ‰āļēāļ—āļĩāđˆāļœāļĨāļīāļ•āļ āļēāļĒāļ™āļ­āļ

āļĒāļ·āļ™āļĒāļąāļ™āļ„āļģāļŠāļąāđˆāļ‡āļ‹āļ·āđ‰āļ­ dropshipÂķ

āđ€āļĄāļ·āđˆāļ­āļŠāđˆāļ‡āļŠāļīāđ‰āļ™āļŠāđˆāļ§āļ™āđ„āļ›āļĒāļąāļ‡āļœāļđāđ‰āļĢāļąāļšāđ€āļŦāļĄāļēāļŠāđˆāļ§āļ‡āđ‚āļ”āļĒāļœāļđāđ‰āļˆāļģāļŦāļ™āđˆāļēāļĒāđāļšāļš dropship āđāļĨāđ‰āļ§ āđƒāļŦāđ‰āļ„āļĨāļīāļāļ›āļļāđˆāļĄāļŠāļĄāļēāļĢāđŒāļ— Dropship āļšāļ™ PO āļ‚āļ­āļ‡āļœāļđāđ‰āļˆāļģāļŦāļ™āđˆāļēāļĒāđ€āļžāļ·āđˆāļ­āđ€āļ›āļīāļ”āđƒāļšāļŠāļąāđˆāļ‡āļ‹āļ·āđ‰āļ­ dropship

Note

āđƒāļšāļŠāļąāđˆāļ‡āļ‹āļ·āđ‰āļ­ dropship āļŠāļēāļĄāļēāļĢāļ–āđ€āļ›āļīāļ”āđ„āļ”āđ‰āļˆāļēāļ PO āļ‚āļ­āļ‡*āļœāļđāđ‰āļĢāļąāļšāđ€āļŦāļĄāļēāļŠāđˆāļ§āļ‡* āđ€āļŠāđˆāļ™āļāļąāļ™ āđ„āļ›āļ—āļĩāđˆ āđāļ­āļ›āļāļēāļĢāļˆāļąāļ”āļ‹āļ·āđ‰āļ­ â€Ģ āļ„āļģāļŠāļąāđˆāļ‡āļ‹āļ·āđ‰āļ­ â€Ģ āđƒāļšāļŠāļąāđˆāļ‡āļ‹āļ·āđ‰āļ­ āđ€āļĨāļ·āļ­āļ PO āļˆāļēāļāļ™āļąāđ‰āļ™āļ„āļĨāļīāļāļ›āļļāđˆāļĄāļŠāļĄāļēāļĢāđŒāļ— Resupply

āļŠāļļāļ”āļ—āđ‰āļēāļĒ āļ„āļĨāļīāļāļ›āļļāđˆāļĄ āļ•āļĢāļ§āļˆāļŠāļ­āļš āļ—āļĩāđˆāļ”āđ‰āļēāļ™āļšāļ™āđ€āļžāļ·āđˆāļ­āļĒāļ·āļ™āļĒāļąāļ™āļ§āđˆāļēāļœāļđāđ‰āļĢāļąāļšāđ€āļŦāļĄāļēāļŠāđˆāļ§āļ‡āđ„āļ”āđ‰āļĢāļąāļšāļŠāļīāđ‰āļ™āļŠāđˆāļ§āļ™āđāļĨāđ‰āļ§ āļˆāļēāļāļ™āļąāđ‰āļ™āļœāļđāđ‰āļĢāļąāļšāđ€āļŦāļĄāļēāļŠāđˆāļ§āļ‡āļˆāļ°āđ€āļĢāļīāđˆāļĄāļāļēāļĢāļœāļĨāļīāļ•āļŠāļīāļ™āļ„āđ‰āļēāļ‚āļąāđ‰āļ™āļŠāļļāļ”āļ—āđ‰āļēāļĒ

āļ‚āļąāđ‰āļ™āļ•āļ­āļ™āļāļēāļĢāđ„āļ”āđ‰āļĢāļąāļšāđ€āļ­āļāļŠāļēāļĢÂķ

After the subcontractor completes production, the finished product is shipped to the company.

āđ€āļžāļ·āđˆāļ­āļĢāļąāļšāļŠāļīāļ™āļ„āđ‰āļēāđ€āļ‚āđ‰āļēāļŠāļ•āđ‡āļ­āļ āđ„āļ›āļ—āļĩāđˆ āđāļ­āļ›āļāļēāļĢāļˆāļąāļ”āļ‹āļ·āđ‰āļ­ â€Ģ āļ„āļģāļŠāļąāđˆāļ‡āļ‹āļ·āđ‰āļ­ â€Ģ āđƒāļšāļŠāļąāđˆāļ‡āļ‹āļ·āđ‰āļ­ āđāļĨāļ°āđ€āļĨāļ·āļ­āļ PO āļ‚āļ­āļ‡*āļœāļđāđ‰āļĢāļąāļšāđ€āļŦāļĄāļēāļŠāđˆāļ§āļ‡*

āļ—āļĩāđˆāļ”āđ‰āļēāļ™āļšāļ™āļ‚āļ­āļ‡ PO āļ„āļĨāļīāļāļ›āļļāđˆāļĄ āļĢāļąāļšāļŠāļīāļ™āļ„āđ‰āļē āļŦāļĢāļ·āļ­āļ„āļĨāļīāļāļ›āļļāđˆāļĄāļŠāļĄāļēāļĢāđŒāļ— āđƒāļšāļĢāļąāļš āļˆāļēāļāļ™āļąāđ‰āļ™āļ„āļĨāļīāļ āļ•āļĢāļ§āļˆāļŠāļ­āļš āđ€āļžāļ·āđˆāļ­āļšāļąāļ™āļ—āļķāļāļāļēāļĢāļˆāļąāļ”āļŠāđˆāļ‡āļ‚āļēāđ€āļ‚āđ‰āļēāđƒāļ™āļ„āļĨāļąāļ‡āļŠāļīāļ™āļ„āđ‰āļē

Note

āļŦāļēāļāđ€āļ›āļīāļ”āđƒāļŠāđ‰āļ‡āļēāļ™ āļ‚āļąāđ‰āļ™āļ•āļ­āļ™āļāļēāļĢāļˆāļąāļ”āļāļēāļĢāļ„āļĨāļąāļ‡āļŠāļīāļ™āļ„āđ‰āļēāđāļšāļšāļŦāļĨāļēāļĒāļ‚āļąāđ‰āļ™āļ•āļ­āļ™ āļˆāļ°āļ•āđ‰āļ­āļ‡āļĄāļĩāļāļēāļĢāļ•āļĢāļ§āļˆāļŠāļ­āļšāļāļēāļĢāđ‚āļ­āļ™āļĒāđ‰āļēāļĒāđ€āļžāļīāđˆāļĄāđ€āļ•āļīāļĄāđ€āļžāļ·āđˆāļ­āļšāļąāļ™āļ—āļķāļāļŠāļīāļ™āļ„āđ‰āļēāđ€āļ‚āđ‰āļēāļŠāļđāđˆāļ„āļĨāļąāļ‡

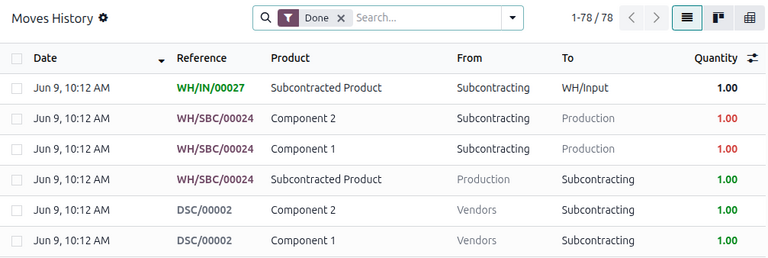

āļ•āļīāļ”āļ•āļēāļĄāļāļēāļĢāđ€āļ„āļĨāļ·āđˆāļ­āļ™āđ„āļŦāļ§āļŠāļīāļ™āļ„āđ‰āļēāđƒāļ™āļ„āļĨāļąāļ‡Âķ

After validating a receipt, NightPOS automatically generates inventory moves to track the movement of subcontracted products between locations. To view these inventory moves, navigate to Inventory app â€Ģ Reporting â€Ģ Moves History.

In the Dropship to Subcontractor workflow, product components are first sent from the vendors to a dedicated location called Subcontracting. Another location called Production then consumes the components and produces the finished good. Once produced, the good then moves back to the Subcontracting location before finally entering the contractor's stock when the receipt is validated.

āļ›āļĢāļ°āļ§āļąāļ•āļīāļāļēāļĢāđ€āļ„āļĨāļ·āđˆāļ­āļ™āļĒāđ‰āļēāļĒāļŠāļģāļŦāļĢāļąāļšāđ€āļ§āļīāļĢāđŒāļāđ‚āļŸāļĨāļ§āđŒ dropship to subcontractor
